Urban batch construction land
Urban batch construction land
Concept
The Land Management Law stipulates that "within the scope of construction land scale determined by the overall land use plan for cities, villages, and towns, if agricultural land is converted into construction land for the implementation of the plan, it shall be divided into batches according to the annual land use plan and approved by the authority that originally approved the overall land use plan. The plan has determined the scale of urban construction land. For land within the circle that involves agricultural land, it is divided into batches for approval according to the land use calculation, which is called urban construction land in batches.
Essential materials
Boundary survey materials, planning/land type/ownership materials; In addition to the materials required for separate site selection projects involving land acquisition, additional land acquisition and development plans need to be supplemented; For those involving the conversion of agricultural land, it is necessary to supplement the agricultural conversion plan, land supply plan, etc; Meanwhile, depending on the location of the project red line, additional materials may need to be supplemented as needed; For example, if it involves occupying arable land, it is necessary to supplement relevant materials for balancing arable land occupation and compensation.
Land approval process
The approval logic for batch land use projects is similar to that of individual site selection projects, but the specific work subject is different. The natural resources department of the city or county at or above the prefecture level should carry out the grouping work and report it. ###Approved by the State Council
- Expropriating permanent basic farmland;
- Expropriating more than 35 hectares of arable land other than permanent basic farmland;
- Expropriate other land exceeding 70 hectares. In addition, road, pipeline engineering, and large-scale infrastructure construction projects approved by the provincial people's government, as well as construction projects approved by the State Council and its investment supervisory departments that occupy land and involve the conversion of agricultural land to construction land, shall be approved by the State Council and the land acquisition approval procedures shall be handled at the same time. Approved by the Provincial People's Government
Provincial government
If the area of arable land other than permanent basic farmland that needs to be converted or expropriated at once is less than 35 hectares, and the area of other land expropriated is less than 70 hectares, it shall be reported to the provincial people's government for approval step by step. The conversion of agricultural land outside of permanent basic farmland within the urban development boundary of Kunming City shall be approved by the Yunnan Provincial People's Government.
Municipal People's Government

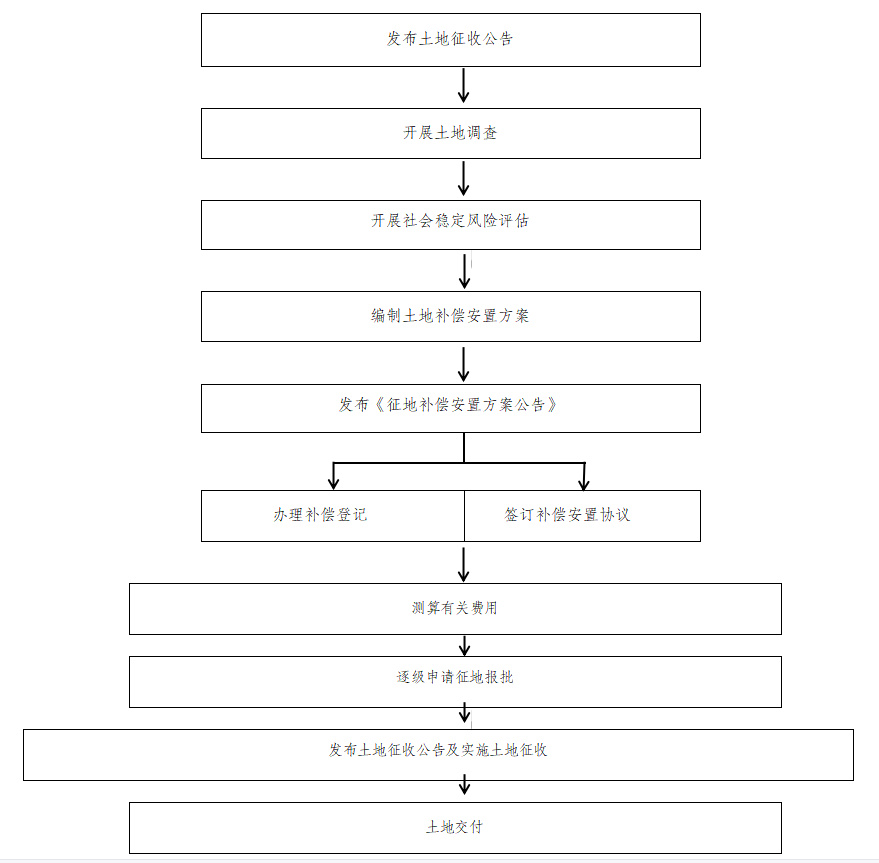

The conversion of agricultural land outside of permanent basic farmland within the boundaries of village planning and construction shall be approved by the Municipal People's Government. ##Land acquisition process

Typical case
###The first batch of urban and rural construction land increase and decrease linkage projects in Zhuozhou City in 2023 The first batch of urban and rural construction land increase and decrease linkage projects in Zhuozhou City in 2023 are divided into 11 plots, involving 12 administrative villages including Beihuning Village, Sunjiazhuang, Dongguqiu Village, Qizhuang, Du Village, Shanghuliang Village, Wangjiafen, Tong Village, Beima Village, Qianpu Village, Zhonghuliang Village, and Lianzhuang Village. The total construction scale is 42.4323 hectares, and it is expected to add 42.4323 hectares of arable land after the implementation of the project.
River replacement project
This plan aims to implement rural water source replacement for the remaining 296 rural areas in Zhuozhou City, involving a rural population of 343400. The provincial-level construction project only designs the South to North Water Diversion Project, two surface water plant raw water pipelines, and some surface water plant to distribution station water supply pipeline projects, including the raw water intake project, raw water pipeline project, and water supply pipeline project; The main construction contents of the county-level self raised project include the construction of 2 new surface water plants, 3 new water distribution stations, the expansion of 6 water distribution stations, the installation of 1 new raw water pipeline above the Dongchengfang surface water plant, the installation of water supply pipelines from the Dongchengfang surface water plant to the remaining 5 water distribution stations, the installation of 12 new water distribution stations to each village's water distribution pipeline project, and the renovation and renovation of 24 village pipelines and their supporting metering facilities. Complete project survey and demarcation, preliminary work for land acquisition, review of planning linkage schemes, and submission of land acquisition volume for approval.
Weixian Surveying and Demarcation
Within the development zone of Weixian County, Zhangjiakou, on the north side of Gongye Road East Power Plant, the rights holders are Dagucheng Village and Zhujiazhuang Village in Songjiazhuang Town, Weixian County, with a total surveyed and delineated area of 16.6151 hectares
- According to the natural resources and planning of Weixian County, conduct on-site survey, investigate and measure the administrative boundaries and land type boundaries within the land use scope, and draw boundary points for important turning points.
- Investigate the land use, land type, and land grade within the occupied area. Measure the total area of various types of land and the area of various types of land in each county, township, and administrative village, and provide them to Party A as the basis for calculating land acquisition compensation.
- Prepare a survey boundary map and survey boundary report, a summary table of land classification areas, and a result table of the coordinates of the boundary points determined by land survey.
- Other work required for surveying and demarcation.
- Assist in carrying out relevant work related to surveying and demarcation in land registration and approval.
Other
Zhuozhou River Water Exchange Project (surveying and demarcation, social stability risk assessment Permanent Land Acquisition Volume Filing and Approval Pingshan County will add or remove 11 batches in 2023 (Construction Street Bailixi) The first batch of increase and decrease linked projects in Zhuozhou City in 2023
